V-Model in Software Development: Complete Guide to Verification and Validation SDLC
V-Model in Software Development: Complete Guide to Verification and Validation SDLC
The V-Model stands as one of the most systematic and quality-focused Software Development Life Cycle (SDLC) methodologies, placing verification and validation at the center of every development phase.
Unlike other SDLC approaches, the V-Model creates a direct correspondence between development phases and testing activities, ensuring that quality is built into the software from the ground up rather than tested in at the end.
This comprehensive guide explores advanced V-Model implementation strategies, regulatory compliance applications, and modern adaptations that integrate with Agile methodologies and DevOps practices.
Whether you're developing safety-critical systems, working in regulated industries, or simply committed to delivering the highest quality software, understanding the V-Model's verification and validation approach is essential for project success.
Table Of Contents-
- Understanding the V-Model Framework
- V-Model Implementation Strategy
- When to Use the V-Model
- V-Model Comparisons
- Regulatory Compliance and Standards
- Advanced V-Model Strategies
- Modern V-Model Adaptations
- Tools and Technologies
- Common Implementation Challenges
- Success Metrics and Measurement
- Future Trends and Evolution
- Conclusion and Next Steps
Understanding the V-Model Framework
The V-Model represents a fundamental shift from traditional sequential development approaches by establishing a direct, traceable relationship between each development phase and its corresponding testing activity. This systematic approach ensures that verification ("Are we building the product right?") and validation ("Are we building the right product?") occur throughout the entire development lifecycle.
Core Verification and Validation Principles
The V-Model operates on four foundational principles that distinguish it from other SDLC methodologies:
Early Test Planning: Test cases and acceptance criteria are defined during the corresponding development phase, not after code completion. This approach identifies potential issues before they become expensive problems.
Phase-Gate Quality Control: Each phase must meet specific quality criteria before progression to the next phase. This prevents defects from cascading through the development process.
Traceability Requirements: Every requirement must be traceable from initial specification through final validation, ensuring complete coverage and regulatory compliance.
Systematic Documentation: Comprehensive documentation at each phase supports regulatory audits, knowledge transfer, and long-term maintenance.
Verification vs. Validation: Verification ensures the product is built according to specifications (technical correctness), while validation ensures the product meets user needs and intended purpose (functional appropriateness).

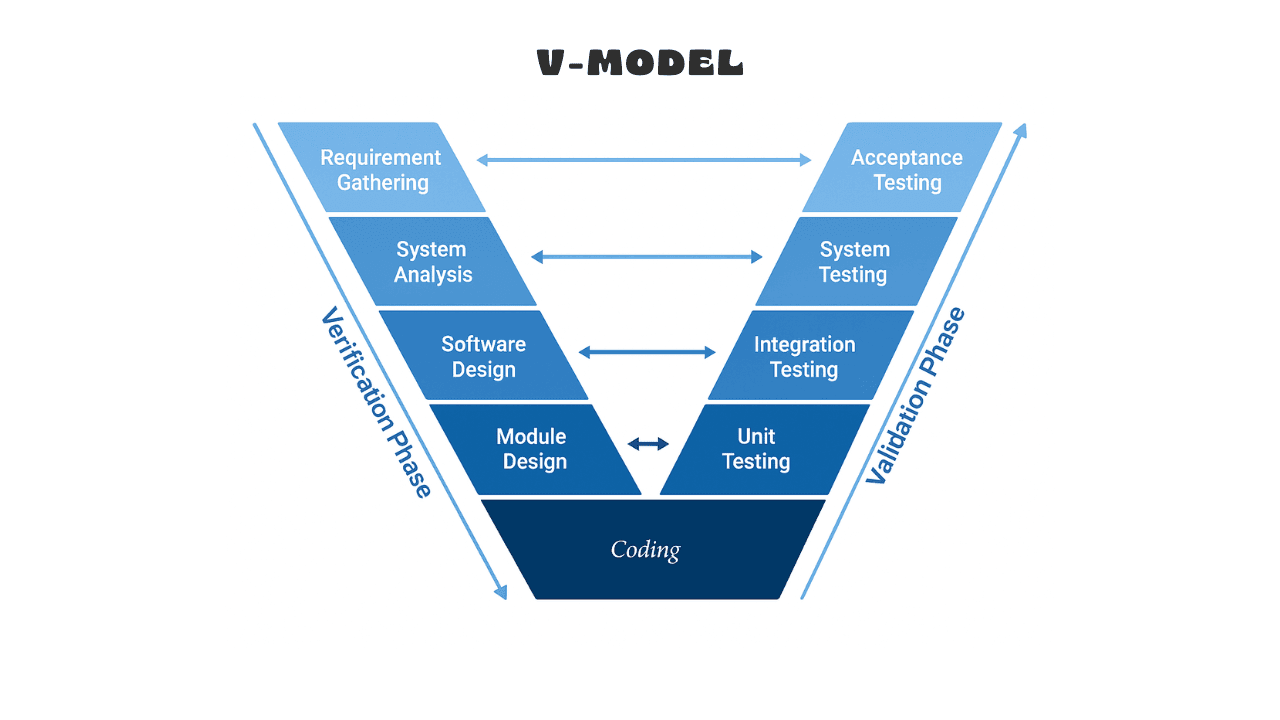

V-Model Visual Structure and Flow
The V-Model's distinctive "V" shape illustrates the relationship between development phases (left side) and testing phases (right side):
Development Phase | Corresponding Test Phase | Primary Focus |
---|---|---|
Requirements Analysis | Acceptance Testing | User needs validation |
System Design | System Testing | End-to-end functionality |
Detailed Design | Integration Testing | Component interaction |
Implementation | Unit Testing | Code-level verification |
The bottom of the "V" represents the implementation phase, where actual coding occurs. As development progresses up the right side, testing becomes increasingly comprehensive, ultimately validating that the complete system meets original requirements.
Phase-by-Phase Correspondence
The V-Model's strength lies in its systematic correspondence between development and testing activities:
Requirements Correspondence: Each business requirement directly maps to acceptance test scenarios, ensuring complete validation coverage.
Design Correspondence: System and detailed design specifications drive comprehensive test planning for integration and system testing phases.
Implementation Correspondence: Code modules undergo immediate unit testing, with test cases derived from detailed design specifications.
This correspondence creates a robust quality framework that prevents requirements from being lost or misinterpreted during development.
V-Model Implementation Strategy
Successful V-Model implementation requires careful planning, resource allocation, and adherence to systematic processes. The following phase-by-phase implementation guide provides practical strategies for maximizing V-Model effectiveness.
Phase 1: Requirements Analysis and Acceptance Test Planning
Duration: 15-25% of total project timeline Key Activities: Business requirements gathering, stakeholder analysis, acceptance criteria definition Deliverables: Requirements specification, acceptance test plan, traceability matrix foundation
Requirements Gathering Process:
- Conduct comprehensive stakeholder interviews and workshops
- Document functional and non-functional requirements with measurable criteria
- Establish requirement priorities and dependencies
- Create user stories and use cases with clear acceptance criteria
Acceptance Test Planning:
- Define test scenarios for each business requirement
- Establish test data requirements and environment specifications
- Create user acceptance test (UAT) procedures and success criteria
- Plan stakeholder involvement in acceptance testing activities
Quality Gates:
- Requirements review and approval by all stakeholders
- Acceptance test plan validation and sign-off
- Traceability matrix establishment and verification
⚠️
Critical Success Factor: Invest adequate time in requirements analysis. Studies show that fixing a requirement defect in production costs 100-200 times more than fixing it during requirements phase.
Phase 2: System Design and System Test Planning
Duration: 20-30% of total project timeline Key Activities: High-level system architecture, interface design, system test strategy Deliverables: System architecture document, interface specifications, system test plan
System Architecture Development:
- Design overall system architecture and technology stack
- Define system interfaces and integration points
- Establish performance, security, and scalability requirements
- Create data flow diagrams and system interaction models
System Test Planning:
- Develop end-to-end test scenarios covering all system functions
- Plan performance, security, and usability testing approaches
- Define test environments and infrastructure requirements
- Establish system test automation strategies
Integration Planning:
- Identify all internal and external system interfaces
- Plan integration test sequences and dependency management
- Define interface test cases and validation criteria
- Establish integration environment requirements
Phase 3: Detailed Design and Integration Test Planning
Duration: 15-20% of total project timeline Key Activities: Component design, database design, integration test specification Deliverables: Detailed design documents, database schema, integration test plan
Component Design:
- Break down system architecture into detailed components
- Define component interfaces, inputs, outputs, and processing logic
- Design database schema, tables, relationships, and access patterns
- Create detailed technical specifications for each component
Integration Test Planning:
- Design test cases for component-to-component interactions
- Plan integration test sequences (big bang vs. incremental)
- Define test data and mock service requirements
- Establish integration test automation frameworks
Phase 4: Implementation and Unit Testing
Duration: 25-35% of total project timeline Key Activities: Code development, unit test creation, code review Deliverables: Source code, unit test suites, code coverage reports
Development Best Practices:
- Follow coding standards and architectural guidelines
- Implement comprehensive error handling and logging
- Create modular, testable code with clear interfaces
- Maintain code documentation and inline comments
Unit Testing Strategy:
- Achieve minimum 80% code coverage for critical components
- Implement automated unit test execution in development environment
- Use test-driven development (TDD) practices where appropriate
- Create unit tests for edge cases and error conditions
Quality Assurance:
- Conduct peer code reviews for all developed components
- Run static code analysis tools to identify potential issues
- Perform security scanning and vulnerability assessment
- Validate coding standards compliance
Phase 5: Integration Testing
Duration: 10-15% of total project timeline Key Activities: Component integration, interface testing, integration defect resolution Deliverables: Integration test results, interface validation reports, integrated system
Integration Approaches:
Approach | Description | Best for | Challenges |
---|---|---|---|
Big Bang | Integrate all components simultaneously | Small systems | Difficult defect isolation |
Top-down | Start with top-level modules | UI-heavy applications | Requires extensive stubs |
Bottom-up | Start with low-level modules | Data-processing systems | Requires test drivers |
Sandwich | Combine top-down and bottom-up | Complex systems | Resource intensive |
Integration Test Execution:
- Execute interface test cases systematically
- Validate data flow between integrated components
- Test error handling across component boundaries
- Verify performance under integrated load conditions
Phase 6: System Testing
Duration: 15-20% of total project timeline Key Activities: End-to-end testing, performance testing, security testing Deliverables: System test results, performance reports, security assessment
System Test Categories:
Functional Testing:
- End-to-end business process validation
- Cross-browser and cross-platform compatibility
- User interface and user experience testing
- Business rule and workflow validation
Non-Functional Testing:
- Performance testing under various load conditions
- Security testing including penetration testing
- Usability testing with target user groups
- Reliability and availability testing
Environmental Testing:
- Production-like environment validation
- Disaster recovery and backup testing
- Scalability and capacity planning validation
- Integration with external systems testing
Phase 7: Acceptance Testing
Duration: 10-15% of total project timeline Key Activities: User acceptance testing, business validation, production readiness Deliverables: UAT results, business sign-off, production deployment approval
Acceptance Testing Types:
User Acceptance Testing (UAT):
- Business users validate system meets requirements
- Real-world scenario testing with actual business data
- Workflow validation in realistic business contexts
- User training and documentation validation
Business Acceptance Testing (BAT):
- Senior stakeholders approve business value delivery
- Return on investment (ROI) validation
- Strategic alignment confirmation
- Go-live decision making
Operational Acceptance Testing (OAT):
- IT operations validate system maintainability
- Backup and recovery procedure testing
- Monitoring and alerting system validation
- Support process and documentation review
When to Use the V-Model
The V-Model excels in specific project contexts where quality, traceability, and systematic validation are paramount. Understanding when to apply the V-Model ensures optimal project outcomes and resource utilization.
Ideal Project Characteristics
The V-Model is most effective for projects with the following characteristics:
Well-Defined Requirements: Projects with stable, clearly articulated requirements that are unlikely to change significantly during development.
Quality-Critical Applications: Systems where failure could result in safety risks, financial losses, or regulatory violations.
Regulatory Compliance Needs: Projects requiring comprehensive documentation and traceability for regulatory audits and certifications.
Complex Integration Requirements: Systems with multiple internal and external integration points requiring systematic validation.
Experienced Development Teams: Teams with strong testing expertise and familiarity with systematic development processes.
Industry Applications
The V-Model has proven particularly effective in the following industries:
Healthcare and Medical Devices:
- FDA-regulated medical device software
- Electronic health record (EHR) systems
- Clinical trial management systems
- Medical imaging and diagnostic software
Automotive Industry:
- Safety-critical automotive systems (ADAS, braking systems)
- Infotainment and navigation systems
- Electric vehicle battery management systems
- Autonomous driving software components
Aerospace and Defense:
- Flight control and navigation systems
- Satellite communication systems
- Military command and control software
- Air traffic management systems
Financial Services:
- Banking core systems and payment processing
- Trading platforms and risk management systems
- Regulatory reporting and compliance systems
- Insurance claims processing systems
Telecommunications:
- Network management and monitoring systems
- Billing and customer management platforms
- 5G infrastructure software
- Emergency communication systems
Decision Framework
Use this decision matrix to evaluate V-Model suitability for your project:
Factor | V-Model Favors | Alternative Approaches |
---|---|---|
Requirements Stability | Stable, well-defined | Agile for evolving requirements |
Quality Criticality | Safety/mission-critical | Spiral for high-risk projects |
Regulatory Environment | Highly regulated | Waterfall for simple compliance |
Team Experience | Testing-experienced | Agile for learning teams |
Project Size | Medium to large | Kanban for small projects |
Timeline Constraints | Adequate time for testing | Iterative for time-pressured projects |
Decision Tip: If 4 or more factors favor the V-Model, it's likely the optimal choice. For mixed results, consider hybrid approaches combining V-Model principles with other methodologies.
V-Model Comparisons
The V-Model's systematic verification and validation approach distinguishes it from other SDLC methodologies. Understanding these differences helps teams select the optimal methodology for their project requirements.
V-Model Methodology Comparisons:
-
V-Model vs Waterfall Model: Compare verification-driven testing with documentation-driven sequential development for quality-critical projects.
-
V-Model vs Agile Methodologies: Analyze systematic validation versus collaborative iteration for regulatory compliance and customer-responsive development.
-
V-Model vs Iterative Model: Examine comprehensive verification versus incremental delivery for risk management and quality assurance.
Each comparison provides detailed analysis, implementation guidance, and decision frameworks to help you choose the most appropriate methodology for your specific project context, regulatory requirements, and quality objectives.
Regulatory Compliance and Standards
The V-Model's systematic approach and comprehensive documentation make it particularly well-suited for regulated industries. Understanding specific regulatory requirements ensures successful compliance and audit readiness.
FDA Medical Device Compliance
The FDA's Quality System Regulation (QSR) and software guidance documents align closely with V-Model principles:
Design Controls (21 CFR 820.30):
- Design planning corresponds to V-Model requirements analysis
- Design inputs align with system and detailed design phases
- Design outputs match implementation and testing phases
- Design verification maps to V-Model verification activities
- Design validation corresponds to V-Model validation testing
Software Documentation Requirements:
- Software requirements specification (SRS)
- Software design specification (SDS)
- Software verification and validation plan (SVVP)
- Software risk management documentation
- Traceability analysis throughout development
V-Model FDA Compliance Implementation:
V-Model Phase | FDA Requirement | Key Deliverables |
---|---|---|
Requirements Analysis | Design Inputs | Software requirements specification |
System Design | Design Outputs | System architecture document |
Detailed Design | Design Outputs | Detailed design specification |
Implementation | Design Outputs | Source code and unit tests |
Integration Testing | Design Verification | Integration test reports |
System Testing | Design Verification | System test reports |
Acceptance Testing | Design Validation | User acceptance test results |
ISO 26262 Automotive Safety
ISO 26262 (Functional Safety for Road Vehicles) mandates systematic development processes that align with V-Model structure:
Safety Lifecycle Integration:
- Hazard analysis and risk assessment during requirements phase
- Safety requirements allocation across system levels
- Safety verification at each development phase
- Safety validation through systematic testing
Automotive Safety Integrity Levels (ASIL):
- ASIL A: Basic integrity requirements
- ASIL B: Enhanced verification activities
- ASIL C: Comprehensive testing and review
- ASIL D: Maximum safety integrity with extensive verification
V-Model ASIL Implementation Strategy:
ASIL Level | V-Model Enhancement | Additional Activities |
---|---|---|
ASIL A | Standard V-Model | Basic safety analysis |
ASIL B | Enhanced reviews | Independent safety assessment |
ASIL C | Formal verification | Diverse redundancy analysis |
ASIL D | Maximum rigor | Independent development teams |
Aerospace and Defense Standards
DO-178C (Software Considerations in Airborne Systems) and similar defense standards require systematic verification and validation:
Software Level Requirements:
- Level A: Catastrophic failure conditions
- Level B: Hazardous failure conditions
- Level C: Major failure conditions
- Level D: Minor failure conditions
- Level E: No safety effect
V-Model DO-178C Alignment:
- Requirements-based testing for all software levels
- Structural coverage analysis for Levels A, B, and C
- Modified condition/decision coverage for Level A
- Comprehensive traceability throughout development
Advanced V-Model Strategies
Modern V-Model implementations incorporate advanced strategies that enhance effectiveness while maintaining systematic rigor. These strategies address contemporary challenges in software development and testing.
Risk-Based Testing Integration
Risk-based testing prioritizes test activities based on risk assessment, optimizing resource allocation and maximizing defect detection:
Risk Assessment Framework:
Risk Factor | Impact Assessment | Probability Assessment | Test Priority |
---|---|---|---|
Safety-critical functions | High impact | Medium probability | Critical |
Complex algorithms | Medium impact | High probability | High |
Third-party integrations | Medium impact | Medium probability | Medium |
Administrative functions | Low impact | Low probability | Low |
Risk-Based Test Strategy Implementation:
- Identify high-risk components during design phases
- Allocate additional testing resources to high-risk areas
- Implement comprehensive test coverage for critical functions
- Use risk assessment to guide test automation priorities
Risk Mitigation Through V-Model Phases:
- Requirements phase: Identify requirement-related risks
- Design phases: Address architectural and integration risks
- Implementation phase: Mitigate coding and unit-level risks
- Testing phases: Validate risk mitigation effectiveness
Traceability Matrix Implementation
Comprehensive traceability ensures complete requirement coverage and supports regulatory compliance:
Traceability Relationships:
Business Requirements → System Requirements → Design Elements → Code Components → Test Cases → Test Results
Traceability Matrix Structure:
Requirement ID | System Design | Detailed Design | Code Module | Unit Test | Integration Test | System Test | Acceptance Test |
---|---|---|---|---|---|---|---|
REQ-001 | SYS-001 | DET-001, DET-002 | MOD-001 | UT-001 | IT-001 | ST-001 | AT-001 |
REQ-002 | SYS-002 | DET-003 | MOD-002 | UT-002 | IT-002 | ST-002 | AT-002 |
Automated Traceability Tools:
- Requirements management platforms (e.g., DOORS, Polarion)
- Test management tools with traceability features
- Code analysis tools for requirement-to-code mapping
- Integrated ALM (Application Lifecycle Management) platforms
Test-Driven Development Alignment
Integrating Test-Driven Development (TDD) principles with V-Model structure enhances code quality and reduces defects:
TDD Integration Strategy:
- Write test cases during design phases (before implementation)
- Use acceptance criteria to drive test case development
- Implement code to satisfy predefined test cases
- Refactor code while maintaining test coverage
TDD Benefits in V-Model Context:
- Earlier defect detection through test-first approach
- Improved code coverage and quality
- Better requirement understanding through test specification
- Reduced debugging time and rework costs
TDD Implementation Timeline:
V-Model Phase | TDD Activity | Deliverable |
---|---|---|
Requirements Analysis | Define acceptance test criteria | Acceptance test scenarios |
System Design | Create system test specifications | System test cases |
Detailed Design | Develop integration test cases | Integration test specifications |
Implementation | Write unit tests before coding | Unit test suites |
Modern V-Model Adaptations
Contemporary software development environments require V-Model adaptations that maintain systematic rigor while embracing modern practices and technologies.
Hybrid V-Model and Agile Approaches
Hybrid approaches combine V-Model's systematic quality assurance with Agile's flexibility and responsiveness:
Agile V-Model (AV-Model) Implementation:
- Maintain V-Model phase structure with shorter iterations
- Implement daily standups and sprint reviews within V-Model phases
- Use user stories and acceptance criteria for requirement specification
- Apply retrospectives for continuous V-Model process improvement
Sprint-Based V-Model Execution:
V-Model Phase | Sprint Duration | Sprint Activities | Sprint Deliverables |
---|---|---|---|
Requirements Analysis | 2-3 sprints | User story creation, acceptance criteria | Product backlog, acceptance tests |
System Design | 3-4 sprints | Architecture design, system planning | System design, test strategy |
Detailed Design | 2-3 sprints | Component design, test planning | Detailed specs, test cases |
Implementation | 4-6 sprints | Code development, unit testing | Working software, unit tests |
Benefits of Hybrid Approach:
- Maintains V-Model quality and traceability
- Provides Agile flexibility and customer involvement
- Enables early feedback while preserving systematic validation
- Supports regulatory compliance with modern development practices
DevOps Integration Strategies
Integrating DevOps practices with V-Model enhances automation, accelerates feedback, and improves deployment reliability:
Continuous Integration (CI) in V-Model:
- Automate unit test execution during implementation phase
- Implement automated code quality checks and security scanning
- Integrate static analysis tools for early defect detection
- Maintain continuous build and test automation
Continuous Deployment (CD) Considerations:
- Implement staged deployment aligned with V-Model test phases
- Use feature flags for controlled release management
- Maintain comprehensive test automation for regression testing
- Implement rollback procedures for failed deployments
Infrastructure as Code (IaC):
- Version control test environments alongside application code
- Automate test environment provisioning and configuration
- Ensure consistent environments across V-Model test phases
- Implement environment-specific configuration management
DevOps Tool Integration:
V-Model Phase | DevOps Tools | Integration Purpose |
---|---|---|
Requirements | JIRA, Azure DevOps | Requirement tracking and traceability |
Design | Confluence, SharePoint | Design documentation and collaboration |
Implementation | Git, Jenkins, SonarQube | Code versioning, CI/CD, quality analysis |
Testing | Selenium, TestRail | Test automation and management |
Deployment | Docker, Kubernetes | Containerization and orchestration |
Monitoring | Prometheus, Grafana | Performance monitoring and alerting |
Continuous Integration and V-Model
CI/CD practices enhance V-Model effectiveness by providing rapid feedback and automated quality assurance:
CI Pipeline Design for V-Model:
Code Commit → Static Analysis → Unit Tests → Integration Tests → Security Scan → Build Artifact → Deployment
Automated Testing Strategy:
- Unit tests: 100% automation during implementation phase
- Integration tests: 80-90% automation with critical path coverage
- System tests: 60-70% automation focusing on regression testing
- Acceptance tests: 40-50% automation for key business scenarios
Quality Gates in CI Pipeline:
- Code coverage thresholds (minimum 80% for critical components)
- Static analysis score requirements
- Security vulnerability scanning results
- Performance benchmark validation
- Documentation completeness checks
Tools and Technologies
Selecting appropriate tools and technologies is crucial for successful V-Model implementation. Modern tool ecosystems support comprehensive lifecycle management, from requirements through deployment.
Requirements Management Tools
Effective requirements management forms the foundation of successful V-Model implementation:
Enterprise Requirements Platforms:
Tool | Strengths | Best for | Integration Capabilities |
---|---|---|---|
IBM DOORS | Comprehensive traceability | Large regulated projects | Strong ALM integration |
Polarion | Web-based collaboration | Distributed teams | DevOps tool integration |
Jama Connect | User-friendly interface | Cross-functional teams | Test management tools |
Azure DevOps | Microsoft ecosystem | Agile-V-Model hybrids | Complete DevOps pipeline |
Requirements Management Features:
- Hierarchical requirement organization and categorization
- Bidirectional traceability linking and impact analysis
- Change management and approval workflows
- Baseline management and version control
- Reporting and metrics for requirement coverage analysis
Test Management Platforms
Comprehensive test management supports V-Model's systematic testing approach:
Test Management Solutions:
Platform | Key Features | Integration Strength | Regulatory Support |
---|---|---|---|
TestRail | User-friendly test case management | Wide tool integration | Audit trail and reporting |
Zephyr | Jira-native testing | Atlassian ecosystem | Compliance reporting |
qTest | Enterprise test management | DevOps pipeline integration | Regulatory traceability |
PractiTest | End-to-end test management | Third-party tool connectivity | Comprehensive documentation |
Essential Test Management Capabilities:
- Test case creation, organization, and execution tracking
- Test planning and resource allocation management
- Defect tracking and resolution workflow integration
- Test automation framework integration and reporting
- Metrics and analytics for test coverage and effectiveness
Traceability and Compliance Tools
Traceability tools ensure comprehensive requirement coverage and support regulatory compliance:
Traceability Solutions:
Tool Category | Examples | Primary Function | V-Model Benefit |
---|---|---|---|
ALM Platforms | Polarion, Jama | End-to-end lifecycle | Complete traceability |
Requirements Tools | DOORS, Caliber | Requirement management | Requirements traceability |
Test Management | TestRail, qTest | Test case management | Test traceability |
Code Analysis | SonarQube, Veracode | Code quality analysis | Code-to-requirement linking |
Automated Traceability Features:
- Requirement-to-test case automatic linking
- Code coverage analysis with requirement mapping
- Impact analysis for requirement changes
- Compliance report generation for regulatory audits
- Real-time traceability matrix updates
Compliance Reporting Capabilities:
- FDA 21 CFR Part 11 electronic records compliance
- ISO 26262 safety lifecycle documentation
- DO-178C software development standards
- SOX compliance for financial systems
- GDPR data protection requirement tracking
Common Implementation Challenges
Successful V-Model implementation requires addressing common challenges that can derail projects or reduce methodology effectiveness.
Documentation Overhead
The V-Model's comprehensive documentation requirements can become burdensome without proper management:
Documentation Challenges:
- Excessive documentation creation and maintenance effort
- Documentation that becomes outdated quickly
- Difficulty maintaining consistency across documents
- Storage and retrieval complexity for large documentation sets
Documentation Management Strategies:
Strategy | Implementation | Benefits | Tools |
---|---|---|---|
Living Documentation | Auto-generate from code and tests | Always current | Sphinx, GitBook |
Tiered Documentation | Different detail levels for different audiences | Appropriate depth | Confluence, SharePoint |
Template Standardization | Consistent document structure | Reduced creation effort | Corporate templates |
Collaborative Authoring | Multiple contributors per document | Shared ownership | Google Docs, Notion |
Documentation Optimization Techniques:
- Use automated documentation generation from code comments
- Implement document templates with mandatory sections
- Establish documentation review and approval workflows
- Create document versioning and change control processes
- Implement search and discovery capabilities for large document sets
Timeline and Resource Management
V-Model projects require careful timeline and resource planning to avoid delays and cost overruns:
Common Timeline Challenges:
- Underestimating time required for comprehensive testing
- Inadequate resource allocation for parallel test planning
- Delays in defect resolution impacting downstream phases
- Insufficient time allocation for documentation creation and review
Resource Management Best Practices:
Resource Type | Planning Consideration | Allocation Strategy | Success Metrics |
---|---|---|---|
Testing Resources | 30-40% of total effort | Parallel test planning and execution | Test coverage percentage |
Documentation | 15-20% of development effort | Concurrent with development | Documentation completeness |
Review and QA | 10-15% of phase effort | Built into each phase | Review effectiveness metrics |
Training | 5-10% of project effort | Front-loaded training | Team capability assessment |
Timeline Optimization Strategies:
- Implement overlapping phases where dependencies allow
- Use fast-track approaches for non-critical components
- Establish clear phase-gate criteria to prevent delays
- Implement risk-based prioritization for testing activities
- Create contingency plans for critical path delays
Team Structure and Skill Requirements
V-Model success depends on appropriate team structure and skill development:
Required Skill Sets:
Role | Technical Skills | Process Skills | V-Model Specific |
---|---|---|---|
Business Analyst | Requirements analysis | Stakeholder management | Acceptance criteria definition |
System Architect | System design | Integration planning | Test strategy development |
Developer | Programming languages | Code quality practices | Unit testing expertise |
Test Engineer | Testing frameworks | Test case design | Verification and validation |
Quality Assurance | Quality standards | Process improvement | Traceability management |
Team Structure Considerations:
- Dedicated testing team parallel to development team
- Quality assurance embedded throughout all phases
- Subject matter experts for regulatory compliance
- Documentation specialists for comprehensive documentation
- Configuration management specialists for version control
Skill Development Programs:
- V-Model methodology training for all team members
- Testing technique workshops and certification programs
- Regulatory compliance training for relevant standards
- Tool-specific training for selected technology platforms
- Cross-functional collaboration and communication skills
Success Metrics and Measurement
Effective measurement and metrics provide insights into V-Model implementation success and areas for improvement.
Quality Metrics
Quality metrics demonstrate V-Model effectiveness in delivering high-quality software:
Defect-Related Metrics:
Metric | Target Range | Calculation | Interpretation |
---|---|---|---|
Defect Detection Rate | Over 80% pre-production | (Pre-prod defects / Total defects) × 100 | Higher is better |
Phase Defect Removal | Over 90% per phase | (Phase defects fixed / Phase defects found) × 100 | Process effectiveness |
Defect Escape Rate | Under 5% to production | (Production defects / Total defects) × 100 | Lower is better |
Mean Time to Resolution | Under 2 days critical | Average time from detection to resolution | Process efficiency |
Test Coverage Metrics:
- Requirements coverage: Percentage of requirements with test cases
- Code coverage: Percentage of code executed by tests
- Path coverage: Percentage of execution paths tested
- Boundary value coverage: Coverage of edge cases and limits
Quality Achievement Indicators:
- Customer satisfaction scores and feedback analysis
- System availability and reliability measurements
- Performance benchmarks and SLA compliance
- Security vulnerability assessment results
Process Efficiency Indicators
Process metrics evaluate V-Model implementation efficiency and identify optimization opportunities:
Phase Efficiency Metrics:
Phase | Efficiency Indicator | Target | Measurement Method |
---|---|---|---|
Requirements | Requirement stability | Under 10% change rate | Change request analysis |
Design | Design review effectiveness | Over 95% issue detection | Review outcome tracking |
Implementation | Code quality score | Over 8.0/10 | Static analysis results |
Testing | Test execution efficiency | Over 90% automation | Automated vs manual ratio |
Resource Utilization Metrics:
- Team productivity measurements and trend analysis
- Resource allocation efficiency across phases
- Skill utilization and development progress tracking
- Tool effectiveness and ROI analysis
Timeline Performance Indicators:
- Phase completion accuracy compared to planned schedules
- Critical path adherence and delay impact analysis
- Milestone achievement rates and variance tracking
- Schedule predictability and estimation accuracy
Compliance and Audit Readiness
Compliance metrics ensure regulatory requirements are met and audit readiness is maintained:
Compliance Metrics:
Compliance Area | Metric | Target | Evidence |
---|---|---|---|
Traceability | Requirement coverage | 100% | Traceability matrix |
Documentation | Document completeness | Over 95% | Document checklist |
Process Adherence | Phase gate compliance | 100% | Gate review records |
Risk Management | Risk mitigation rate | Over 90% | Risk register updates |
Audit Readiness Indicators:
- Documentation accessibility and organization quality
- Process evidence availability and completeness
- Traceability link verification and validation
- Change control effectiveness and audit trail integrity
Regulatory Compliance Tracking:
- Standards compliance assessment (FDA, ISO, DO-178C)
- Audit finding resolution time and effectiveness
- Compliance training completion rates for team members
- External assessor feedback and recommendations implementation
Future Trends and Evolution
The V-Model continues evolving to address emerging technologies and development practices while maintaining its core verification and validation principles.
AI-Enhanced Testing
Artificial Intelligence and Machine Learning are transforming V-Model testing practices:
AI Testing Applications:
- Automated test case generation from requirements and user stories
- Intelligent test data creation and management
- Predictive defect analysis and prevention
- Automated test script maintenance and optimization
Machine Learning Integration:
- Pattern recognition for defect prediction based on historical data
- Automated test prioritization based on risk assessment
- Intelligent test coverage analysis and gap identification
- Performance testing optimization through ML algorithms
AI-Powered Quality Assurance:
- Natural language processing for requirement analysis
- Automated documentation review and consistency checking
- Intelligent code review and quality assessment
- Risk-based testing strategy optimization
Model-Based Testing
Model-based testing approaches enhance V-Model systematic validation:
Model-Based Testing Benefits:
- Automated test case generation from system models
- Comprehensive coverage through model exploration
- Early validation through model simulation
- Consistent testing across system levels
Implementation Strategies:
- Create system behavior models during design phases
- Generate test cases automatically from behavioral models
- Validate models through simulation before implementation
- Maintain model-to-code traceability throughout development
Tools and Technologies:
- UML-based modeling tools (Enterprise Architect, MagicDraw)
- Model simulation platforms (MATLAB/Simulink, LabVIEW)
- Automated test generation tools (Conformiq, Microsoft Spec Explorer)
- Model verification and validation platforms
Digital Twin Integration
Digital twins provide virtual replicas for comprehensive system validation:
Digital Twin Applications in V-Model:
- Virtual system testing before physical implementation
- Continuous validation through digital-physical synchronization
- Predictive maintenance and system optimization
- Real-time system monitoring and validation
Implementation Considerations:
- Create digital models during system design phases
- Implement real-time data synchronization mechanisms
- Develop virtual testing environments and scenarios
- Establish digital twin maintenance and evolution processes
Industry Applications:
- Automotive: Vehicle system digital twins for safety validation
- Aerospace: Aircraft system twins for certification support
- Healthcare: Medical device twins for safety and efficacy testing
- Manufacturing: Production system twins for optimization
Conclusion and Next Steps
The V-Model remains a powerful and relevant methodology for quality-driven software development, particularly in regulated industries and safety-critical applications. Its systematic approach to verification and validation provides a robust framework for delivering high-quality software that meets stringent requirements and compliance standards.
Key takeaways from this comprehensive guide:
V-Model Strengths:
- Systematic verification and validation throughout development lifecycle
- Comprehensive traceability from requirements to final validation
- Strong regulatory compliance support and audit readiness
- Early defect detection through parallel test planning
- Quality-focused approach with measurable outcomes
Implementation Success Factors:
- Adequate resource allocation for testing and documentation activities
- Strong team skills in testing methodologies and quality assurance
- Appropriate tool selection for requirements, testing, and traceability
- Executive commitment to quality-first development approach
- Clear understanding of regulatory requirements and compliance needs
Modern Adaptations:
- Integration with Agile practices for increased flexibility
- DevOps automation for enhanced efficiency and feedback
- AI and ML enhancement for intelligent testing and quality assurance
- Cloud-based tools for distributed team collaboration
- Continuous integration and deployment for faster feedback cycles
Next Steps for Implementation:
- Assess your project characteristics against V-Model suitability criteria
- Evaluate team skills and training needs for V-Model implementation
- Select appropriate tools and technologies for your specific context
- Develop implementation roadmap with clear milestones and success metrics
- Consider hybrid approaches that combine V-Model with other methodologies
The V-Model's emphasis on quality, traceability, and systematic validation continues to provide value in an increasingly complex software development landscape. By understanding its principles, implementation strategies, and modern adaptations, teams can leverage the V-Model's strengths while addressing contemporary development challenges.
Whether you're developing medical devices, automotive systems, financial platforms, or any quality-critical software, the V-Model provides a proven framework for systematic verification and validation that ensures your software meets the highest standards of quality and reliability.
Test Your V-Model Knowledge
Quiz on V-Model SDLC
Your Score: 0/15
Question: What does the 'V' shape in the V-Model represent?
Continue Reading
Software Development Life Cycle (SDLC) OverviewGet an overview of the Software Development Life Cycle (SDLC), and learn about the key phases and activities involved.Waterfall Model in SDLCDiscover the ins and outs of the Waterfall model, a fundamental Software Development Life Cycle (SDLC) methodology. Learn its advantages and disadvantages.Spiral Model in Software DevelopmentMaster the Spiral Model with our comprehensive guide. Learn Barry Boehm's risk-driven approach, visual representation, implementation strategies, and modern applications for complex software projects.Agile Methodology OverviewExplore the core values, principles, and practices of Agile methodology and learn how it can revolutionize your software development process.Iterative Model in SDLCLearn about the Iterative model in software development, its advantages, disadvantages, and when to use this incremental approach for your projects.Testing Phase in SDLCExplore the SDLC testing phase and its critical role in ensuring software quality and reliability. Learn about different testing types, methodologies, and their importance.Effective Requirements Gathering: Techniques and TipsDiscover effective strategies for business analysts to master requirements gathering, ensuring projects are built on clear, actionable requirements.Learn about Scrum and PSM-1 CertificationLearn about the PSM-1™ Certification for Scrum, its importance, and how to prepare for the exam to boost your Scrum Master career.
Frequently Asked Questions
Frequently Asked Questions (FAQs) / People Also Ask (PAA)
How does the V-Model compare to Test-Driven Development (TDD) in terms of testing approach?
What team psychology and change management considerations are important for V-Model success?
How does organization size affect V-Model implementation effectiveness?
What are the cost implications and ROI considerations for implementing the V-Model?
How does the V-Model handle technical debt management compared to Agile approaches?
What compliance and regulatory advantages does the V-Model provide over other methodologies?
How does the V-Model accommodate global and distributed development teams?
What environmental and sustainability considerations relate to V-Model software development?
How does the V-Model integrate with performance management and professional development?
How does the V-Model support diversity, equity, and inclusion (DEI) initiatives in software development?
What cybersecurity considerations are specific to V-Model implementation?
How does the V-Model handle innovation projects versus production maintenance work?
What data privacy and GDPR considerations apply to V-Model software development?
How does V-Model implementation vary across different industry sectors?
What are the long-term maintenance and evolution challenges specific to V-Model projects?
