Agile vs Waterfall

Agile vs. Waterfall: Comparing Project Management Approaches

Agile vs. Waterfall: Comparing Project Management ApproachesAgile vs. Waterfall: Comparing Project Management Approaches

Agile and Waterfall represent two fundamentally different approaches to project management and software development. Waterfall follows a linear, sequential path where each phase must be completed before the next begins, while Agile embraces iterative cycles with continuous feedback and adaptation. Understanding the differences between these methodologies is critical for selecting the right approach for your projects.

The choice between Agile and Waterfall can determine project success or failure. According to the 2020 Standish Group Chaos Study (opens in a new tab), Agile projects are three times more likely to succeed compared to Waterfall projects. However, this doesn't mean Agile is always the right choice—certain projects with stable requirements and regulatory constraints may benefit from Waterfall's structured approach.

This comprehensive guide explores the 12 key differences between Agile and Waterfall, provides detailed decision frameworks for choosing the right methodology, examines hybrid approaches, and offers industry-specific recommendations to help you make informed decisions for your projects.

Quick Answer: Agile vs Waterfall at a Glance

AspectAgileWaterfall
ApproachIterative and incrementalLinear and sequential
FlexibilityHigh - welcomes changeLow - follows fixed plan
Customer InvolvementContinuous throughout projectBeginning and end only
DeliveryIncremental releases (sprints)Single final delivery
Best ForEvolving requirementsStable, well-defined projects
Risk DiscoveryEarly in each iterationLate in project lifecycle
DocumentationLightweight, evolvingComprehensive upfront

Agile and Waterfall Overview

Understanding the fundamental differences between these two methodologies is essential for making informed project management decisions.

What is Agile?

Agile is an iterative and incremental approach to project management and software development that prioritizes flexibility, collaboration, and continuous customer feedback. The methodology breaks projects into small, manageable iterations called sprints (typically 1-4 weeks), with each sprint delivering a working increment of the product.

Key Characteristics of Agile:

  • Embraces change and adapts to evolving requirements
  • Delivers working software in short iterations
  • Encourages continuous collaboration between cross-functional teams
  • Values customer feedback throughout the development process
  • Focuses on individuals and interactions over processes and tools
  • Maintains lightweight documentation that evolves with the project

While Agile originated in software development, it can be applied to any project where requirements evolve or are not fully known at the project's outset.

What is Waterfall?

Waterfall is a linear and sequential approach to project management where each phase must be completed in its entirety before the next phase begins. Like a cascading waterfall, the project flows steadily from one stage to the next with no backward movement.

Key Characteristics of Waterfall:

  • Follows a rigid, predetermined plan with clearly defined phases
  • Requires comprehensive upfront planning and documentation
  • Emphasizes thorough requirements gathering before development
  • Provides predictable timelines and deliverables
  • Suitable for projects with stable, well-understood requirements
  • Limits changes once a phase is completed

The phases of waterfall project management are:

Planning

The project is planned in detail.

Requirement Analysis

The project is defined and the requirements are gathered.

Design

In the design phase, the project team translates the requirements into a detailed design specification.

Development

The development phase is when the actual coding and programming take place.

Testing

During the testing phase, the software is put through a series of tests to identify and fix defects.

Deployment

Once the software has passed the testing phase, it's ready for deployment.

Maintenance

The final stage of the SDLC is maintenance.

12 Key Differences Between Agile and Waterfall

The choice between Agile and Waterfall hinges on understanding how these methodologies differ across multiple dimensions. Here's a comprehensive comparison:

FactorAgileWaterfall
1.ApproachIterative and incremental developmentLinear and sequential phases
2.FlexibilityHighly adaptable to changing requirementsRigid adherence to initial plan
3.Customer InvolvementContinuous collaboration throughout projectPrimarily at requirements and delivery stages
4.Delivery ModelFrequent incremental releases (every 1-4 weeks)Single delivery at project completion
5.DocumentationLightweight and evolving documentationComprehensive upfront documentation
6.Risk ManagementEarly and continuous risk identificationRisks often discovered late in lifecycle
7.TestingContinuous testing throughout developmentDedicated testing phase after development
8.Team StructureSelf-organizing, cross-functional teamsHierarchical with specialized roles
9.PlanningAdaptive planning throughout project lifecycleExtensive upfront planning
10.Scope ChangesWelcomes and accommodates changesChanges are costly and discouraged
11.Project TimelineVariable timeline with fixed iterationsFixed timeline determined upfront
12.Success MetricsWorking software and customer satisfactionAdherence to plan, budget, and timeline

Table 1: Comprehensive Comparison of Agile and Waterfall Methodologies

Detailed Factor Analysis

1. Approach and Philosophy

  • Agile: Breaks work into small iterations (sprints), delivering potentially shippable increments regularly. Teams adapt based on feedback and changing priorities.
  • Waterfall: Follows a strict sequence—requirements, design, implementation, testing, deployment, maintenance. Each phase gates the next.

2. Flexibility and Change Management

  • Agile: Embraces change as a competitive advantage. Requirements can evolve based on market feedback and emerging insights.
  • Waterfall: Changes require formal change control processes, often resulting in significant cost and schedule impact.

3. Customer and Stakeholder Engagement

  • Agile: Product owners and stakeholders participate in sprint reviews, backlog refinement, and provide continuous feedback.
  • Waterfall: Customers define requirements at the start and typically see the product only at final delivery or major milestones.

4. Delivery Cadence

  • Agile: Delivers working software every sprint, providing value incrementally and enabling early ROI.
  • Waterfall: No working product until final delivery, delaying value realization until project completion.

5. Documentation Practices

  • Agile: Maintains just enough documentation to support development and knowledge transfer. Documentation evolves with the product.
  • Waterfall: Requires detailed specifications, design documents, test plans before development begins. Documentation is often extensive.

6. Risk Identification and Mitigation

  • Agile: Technical risks, integration issues, and requirement misunderstandings surface within first few sprints, allowing early correction.
  • Waterfall: Risks may remain hidden until testing or deployment phases, when fixes are exponentially more expensive.

Pros and Cons Analysis

Each methodology brings distinct advantages and challenges. Understanding these trade-offs is essential for making informed decisions.

Waterfall Pros and Cons

Pros:

  • Clear project structure and timeline
  • Comprehensive documentation for future reference
  • Easy to track progress and measure success

Cons:

  • Limited flexibility to adapt to changing requirements
  • Longer time to market for software products
  • Risk of discovering issues late in the project
ProsCons
1.Clear project structure and timelineLimited flexibility to adapt to changing requirements
2.Comprehensive documentation for future referenceLonger time to market for software products
3.Easy to track progress and measure successRisk of discovering issues late in the project

Table 2: Pros and Cons of the Waterfall model in Software Development Life Cycle

Agile Pros and Cons

Pros:

  • Adaptability: Responds quickly to changing requirements and market conditions
  • Early Value Delivery: Delivers working software incrementally, enabling early ROI
  • Continuous Feedback: Regular stakeholder input ensures product meets actual needs
  • Risk Mitigation: Problems surface early when they're easier and cheaper to fix
  • Team Collaboration: Cross-functional teams improve communication and shared ownership
  • Customer Satisfaction: Frequent releases and feedback loops lead to better alignment with customer expectations

Cons:

  • Less Predictability: Final scope, timeline, and budget are harder to forecast upfront
  • Requires Commitment: Demands continuous stakeholder involvement and availability
  • Documentation Gaps: Lightweight documentation can create knowledge transfer challenges
  • Scope Creep Risk: Flexibility can lead to uncontrolled feature additions
  • Team Dependency: Requires skilled, self-organizing teams comfortable with ambiguity
  • Scaling Challenges: Coordination across multiple Agile teams requires additional frameworks (SAFe, LeSS)
Agile ProsAgile Cons
1.Adaptability to changing requirementsLess predictable timeline and budget
2.Early and incremental value deliveryRequires continuous stakeholder commitment
3.Continuous customer feedbackPotential documentation gaps
4.Early risk identificationSusceptible to scope creep
5.Improved team collaborationDemands skilled, self-organizing teams
6.Higher customer satisfactionChallenging to scale across large organizations

Table 3: Comprehensive Pros and Cons of Agile Methodology

When to Use Agile: 8 Ideal Scenarios

Agile thrives in environments where flexibility, rapid delivery, and customer collaboration are priorities. Choose Agile when:

1. Requirements Are Evolving or Unclear

When you're entering a new market, building an innovative product, or working in a rapidly changing domain where requirements will emerge over time, Agile allows you to adapt as you learn.

Example: A startup building a mobile app in an emerging market where user preferences are unknown.

2. Rapid Time-to-Market Is Critical

When speed is essential and delivering an MVP (Minimum Viable Product) quickly provides competitive advantage, Agile's iterative releases get working software to users faster.

Example: A fintech company launching features to compete with a new market entrant.

3. Continuous Customer Feedback Is Available

When product owners, stakeholders, or end users can provide regular feedback and are willing to participate in sprint reviews and backlog refinement, Agile maximizes value alignment.

Example: Internal business applications where users are readily accessible for feedback sessions.

4. Innovation and Experimentation Are Goals

When exploring new technologies, testing business hypotheses, or creating cutting-edge products, Agile's iterative approach supports experimentation and pivots.

Example: AI/ML product development where algorithms need tuning based on real-world performance.

5. Complex Systems with Integration Risks

When building systems with many moving parts, third-party integrations, or technical unknowns, Agile surfaces integration issues early when they're manageable.

Example: Enterprise software integrating with multiple legacy systems and external APIs.

6. Cross-Functional Team Collaboration Is Possible

When you have or can form self-organizing, cross-functional teams with skills across development, testing, design, and business analysis, Agile leverages collaboration effectively.

Example: Product-focused teams with developers, designers, QA, and product managers co-located or collaborating remotely.

7. Regulatory or Market Changes Are Anticipated

When operating in industries where regulations, compliance requirements, or market conditions change frequently, Agile allows adaptation without project restarts.

Example: Healthcare applications adapting to new HIPAA regulations or COVID-19 telehealth requirements.

8. Budget Flexibility with Fixed Cadence

When your organization can commit to fixed sprint cadences (e.g., 2-week sprints) but needs flexibility in scope, Agile provides predictable rhythm with adaptive planning.

Example: SaaS companies with continuous delivery pipelines and bi-weekly release cycles.


When to Use Waterfall: 8 Ideal Scenarios

Waterfall excels in predictable environments with stable requirements, regulatory constraints, and fixed budgets. Choose Waterfall when:

1. Requirements Are Stable and Well-Defined

When project requirements are clear, documented, and unlikely to change, Waterfall's upfront planning eliminates costly mid-project adjustments.

Example: Migrating a legacy system to a new infrastructure with no feature changes, only technology upgrades.

2. Regulatory or Compliance Requirements Demand Documentation

When industries like healthcare, aviation, or finance require extensive documentation for audits, certifications, or compliance, Waterfall's comprehensive documentation practices are advantageous.

Example: Medical device software requiring FDA approval with full design history files and traceability matrices.

3. Fixed Budget and Timeline Constraints

When contracts, grants, or funding require fixed-price bids with predefined deliverables and timelines, Waterfall provides clearer cost estimation and milestone tracking.

Example: Government contracts with fixed budgets and delivery dates specified in RFPs.

4. Sequential Dependencies Exist

When project phases have strict sequential dependencies—where later work cannot begin until earlier phases complete—Waterfall's linear approach is natural.

Example: Construction projects where foundation work must complete before structural work begins.

5. Limited Customer Availability

When customers or stakeholders cannot commit to continuous involvement and prefer to define requirements upfront and review at the end, Waterfall accommodates this constraint.

Example: External client projects where stakeholders have limited availability for ongoing collaboration.

6. Technology and Tools Are Proven and Stable

When using mature, well-understood technologies with established best practices and minimal risk, Waterfall's predictability is beneficial.

Example: Implementing a standard ERP system (SAP, Oracle) with minimal customization.

7. Large-Scale Infrastructure or Hardware Projects

When projects involve significant hardware components, physical installations, or infrastructure where changes are prohibitively expensive, Waterfall's thorough upfront planning reduces costly rework.

Example: Telecommunications network infrastructure deployment across multiple sites.

8. Team Lacks Agile Experience or Training

When teams are unfamiliar with Agile practices, lack necessary training, or organizational culture resists self-organization, Waterfall's defined roles and processes may be more manageable short-term while building Agile capabilities.

Example: Traditional enterprise IT organizations beginning their Agile transformation journey.


Decision Framework: Choosing the Right Methodology

Selecting between Agile and Waterfall requires evaluating multiple factors specific to your project, organization, and constraints. Use this framework to guide your decision:

Decision Matrix

Evaluation FactorFavors AgileFavors Waterfall
Requirements ClarityUnclear, evolving, or emergentClear, stable, and well-documented
Customer AvailabilityContinuous involvement possibleLimited to upfront and delivery phases
Budget FlexibilityFlexible scope with fixed iterationsFixed budget and scope
Timeline PredictabilityFlexible timeline, value-driven milestonesFixed timeline with predefined deliverables
Change ToleranceWelcomes and expects changesChanges are costly and disruptive
Risk ToleranceEarly discovery and mitigation valuedRisk avoidance through planning
Team ExperienceSkilled, self-organizing teamsDefined roles and hierarchical structure
Regulatory RequirementsMinimal compliance documentationExtensive audit trails and documentation
Project ComplexityComplex with many unknownsWell-understood with proven approaches
Stakeholder EngagementHigh collaboration and feedbackLow involvement after requirements phase

Decision Process

Step 1: Assess Project Characteristics

  • List your project's requirements clarity, complexity, and constraints
  • Identify customer availability and engagement capacity
  • Evaluate regulatory and compliance requirements

Step 2: Evaluate Team and Organizational Factors

  • Assess team experience with each methodology
  • Determine organizational culture and readiness for change
  • Consider existing processes and tool ecosystems

Step 3: Analyze Risk and Success Factors

  • Identify highest risks (technical, market, integration)
  • Determine when those risks should be discovered and mitigated
  • Define what "success" means for your project

Step 4: Consider Hybrid Approaches

  • Evaluate whether combining methodologies addresses your unique constraints
  • Determine which phases benefit from structured planning vs. iterative development

Step 5: Make an Informed Decision

  • Weigh factors using the decision matrix above
  • Document rationale for methodology selection
  • Establish success criteria and checkpoints for evaluation

Key Insight: The methodology choice isn't permanent. Start with the approach that fits current constraints, gather empirical evidence from early phases, and adapt if necessary. Many organizations successfully transition from Waterfall to Agile as capabilities mature.


Agile vs Waterfall: Success Rates from 2020 Standish Group Study

For technology projects, Agile methodologies triumph while traditional approaches falter. The distinction is striking.

According to the 2020 Standish Group Chaos Study (opens in a new tab), Agile Projects are three times more likely to succeed compared to Waterfall projects, which are twice as likely to fail.

Surprisingly, not everyone agrees on this, particularly when discussing technology or software projects.

The project management community initially questioned the value of Agile methodologies.

They have only recently adopted their version of agility, and even now, they continue to argue that traditional methods have a place in technology projects.

Clinging to the past, they advocate for a hybrid Agile approach, whatever that may entail.

Apart from the project management community, most people recognize that extensive upfront planning and plan-driven approaches are likely to fail in fast-paced technology initiatives.

There is ample evidence supporting the superiority of Agile over Waterfall projects.

Data collected over 25 years of studying project success and failure rates paint a clear picture.

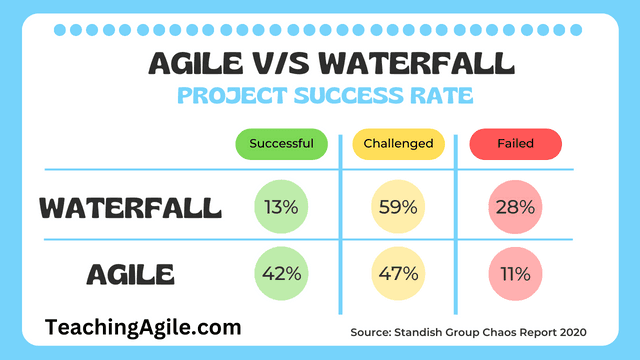

Agile v/s Waterfall based on 2020 Standish Group Chaos StudyAgile v/s Waterfall based on 2020 Standish Group Chaos Study

These findings are based on the Standish Group Chaos Studies, with their latest report from 2020 titled Beyond Infinity.

Like other Standish Group Chaos reports, it is available behind a paywall on the Standish Group website.

💡

Agile projects have twice the likelihood of success and less than half the chance of failure compared to Waterfall projects.

It's essential to note that the success and failure metrics discussed in this article pertain solely to software projects. Information regarding other project types' success and failure rates is unknown.


Hybrid Approaches: Combining Agile and Waterfall

Many organizations find that neither pure Agile nor pure Waterfall fits their unique constraints. Hybrid approaches blend elements of both methodologies to address specific challenges.

Common Hybrid Models

1. Water-Scrum-Fall

Structure: Waterfall planning and design phases → Agile development/testing → Waterfall deployment and maintenance

Use Case: Organizations transitioning to Agile where upstream (requirements) and downstream (deployment) teams remain Waterfall-based while development teams adopt Scrum.

Advantages:

  • Provides structure for teams new to Agile
  • Accommodates regulatory documentation requirements
  • Maintains compatibility with Waterfall-based project management offices

Disadvantages:

  • Can create bottlenecks at phase transitions
  • Reduces Agile's flexibility benefits
  • May perpetuate siloed team structures

2. Agile with Stage Gates

Structure: Iterative Agile development with predefined decision gates at major milestones

Use Case: Product development in industries requiring regulatory approvals, safety certifications, or board-level funding decisions.

Advantages:

  • Combines Agile flexibility with governance checkpoints
  • Enables early-stage experimentation with controlled investment
  • Provides executive visibility and control points

Disadvantages:

  • Stage gates can slow momentum
  • May discourage experimentation if gate criteria are too rigid

3. Disciplined Agile Delivery (DAD)

Structure: Context-sensitive framework offering multiple lifecycle options (Agile, Lean, Continuous Delivery) based on project characteristics

Use Case: Large organizations with diverse project portfolios requiring tailored approaches for different contexts.

Advantages:

  • Provides guided selection based on project factors
  • Offers flexibility across organization
  • Includes full delivery lifecycle (not just construction)

4. Scaled Agile Framework (SAFe)

Structure: Three levels—Team (Scrum/XP), Program (Agile Release Trains), Portfolio (Lean Portfolio Management)

Use Case: Large enterprises coordinating multiple Agile teams delivering complex systems.

Advantages:

  • Aligns multiple teams toward common objectives
  • Provides roles, ceremonies, and artifacts for scale
  • Balances Agile team autonomy with enterprise alignment

Selecting a Hybrid Approach

When Hybrid Makes Sense:

  • Regulatory compliance requires extensive documentation, but development benefits from iterations
  • Upstream/downstream teams cannot adopt Agile, but development teams can
  • Hardware and software components require different cadences
  • Executive governance requires stage gates, but teams need flexibility within stages

When to Avoid Hybrid:

  • Hybrid becomes an excuse for not committing to change
  • Teams lack clarity on when to apply which methodology
  • Hybrid creates unnecessary complexity without addressing actual constraints
⚠️

Caution: Hybrid approaches work best when deliberately designed for specific constraints, not as a compromise to avoid organizational change. Ensure your hybrid model solves real problems rather than creating complexity.


Industry-Specific Recommendations

Different industries face unique constraints that influence methodology selection. Here's guidance tailored to common sectors:

Software as a Service (SaaS)

Recommended: Agile (Scrum, Kanban)

Rationale: Continuous delivery, rapid feature iteration, and customer feedback loops align perfectly with Agile principles.

Key Success Factors:

  • Invest in CI/CD automation
  • Establish feature flags for controlled rollouts
  • Implement strong monitoring and rollback capabilities

Financial Services and Banking

Recommended: Hybrid (Agile development with Waterfall compliance gates)

Rationale: Regulatory requirements (SOC 2, PCI-DSS, banking regulations) demand documentation, but competitive pressure requires speed.

Key Success Factors:

  • Integrate compliance reviews into sprint processes
  • Automate security scanning and testing
  • Document as you go, not after the fact

Healthcare and Medical Devices

Recommended: Waterfall for FDA-regulated devices; Agile for non-regulated healthcare IT

Rationale: FDA-regulated medical devices require extensive design documentation and traceability. Healthcare IT systems benefit from Agile's adaptability.

Key Success Factors:

  • For regulated: Implement Agile-inspired documentation practices within Waterfall
  • For non-regulated: Ensure HIPAA compliance through automated security testing
  • Use risk-based approaches to prioritize compliance efforts

E-commerce and Retail

Recommended: Agile (Scrum for features, Kanban for operations)

Rationale: Market dynamics, seasonal demands, and customer behavior data drive constant optimization.

Key Success Factors:

  • A/B testing and data-driven decisions
  • Peak season readiness (Black Friday, holidays)
  • Performance optimization and scalability

Government and Public Sector

Recommended: Hybrid or Modified Agile with enhanced documentation

Rationale: Procurement processes, fixed budgets, and public accountability require predictability, but complex systems benefit from iterative development.

Key Success Factors:

  • Align Agile practices with Federal Acquisition Regulations (FAR)
  • Maintain traceability from requirements to delivered features
  • Use modular contracting to enable incremental delivery

Telecommunications and Infrastructure

Recommended: Waterfall for network infrastructure; Agile for software and customer-facing applications

Rationale: Physical infrastructure has high change costs. Software and digital services require rapid iteration.

Key Success Factors:

  • Plan infrastructure capacity ahead of software feature releases
  • Use DevOps practices for network configuration management
  • Coordinate hardware and software release cadences

Startups and Innovation Labs

Recommended: Agile (Scrum, XP, or Lean Startup)

Rationale: Uncertainty, rapid learning, and pivot potential make Agile's adaptability essential.

Key Success Factors:

  • Validate assumptions with MVPs before scaling
  • Maintain close customer contact and feedback loops
  • Balance speed with technical debt management

Enterprise IT and Internal Systems

Recommended: Agile for new development; Kanban for maintenance and support

Rationale: Internal systems benefit from continuous feedback, but diverse stakeholders and legacy integrations require adaptability.

Key Success Factors:

  • Engage business stakeholders as Product Owners
  • Address technical debt proactively
  • Implement service-level agreements (SLAs) for support work

Common Selection Mistakes to Avoid

Choosing the wrong methodology—or implementing the right one poorly—can doom projects. Avoid these frequent pitfalls:

Mistake #1: Choosing Agile Because "Everyone Else Is"

Problem: Adopting Agile due to industry trends without assessing whether it fits your project's actual constraints and organizational readiness.

Why It's Problematic: Agile requires significant organizational change, skilled teams, and stakeholder commitment. Without these, Agile projects struggle.

Fix:

  • Conduct honest assessment of your readiness (team skills, stakeholder availability, organizational culture)
  • Start with a pilot project to learn before scaling
  • Invest in training and coaching

Prevention: Use the decision framework above to evaluate whether Agile genuinely addresses your project's risks and constraints.

Mistake #2: Using Waterfall for Complex, Uncertain Projects

Problem: Applying Waterfall to projects with unclear requirements, new technologies, or rapidly changing markets.

Why It's Problematic: Waterfall assumes requirements are knowable upfront. Complex, uncertain projects discover requirements through doing, making Waterfall's upfront planning unreliable.

Fix:

  • Transition to Agile or at least introduce iterative prototyping phases
  • Plan for requirements evolution with change management processes
  • Shorten Waterfall phases to enable faster feedback

Prevention: Assess requirement stability honestly. If substantial uncertainty exists, favor iterative approaches.

Mistake #3: Agile Without Continuous Stakeholder Involvement

Problem: Teams adopt Agile but stakeholders remain unavailable for sprint reviews, backlog refinement, and feedback.

Why It's Problematic: Agile's value comes from continuous feedback loops. Without stakeholder engagement, teams build features that miss the mark.

Fix:

  • Secure executive sponsorship requiring stakeholder participation
  • Designate empowered Product Owners with decision authority
  • Schedule recurring stakeholder meetings as non-negotiable commitments

Prevention: Before committing to Agile, validate stakeholder availability and willingness to engage continuously.

Mistake #4: Fake Agile (Agile in Name Only)

Problem: Organizations rename existing Waterfall phases as "sprints" without adopting Agile principles, practices, or mindsets.

Why It's Problematic: Teams experience Agile's overhead (meetings, ceremonies) without its benefits (flexibility, rapid feedback, early risk discovery).

Fix:

  • Commit to genuine transformation or stick with Waterfall honestly
  • Bring in experienced Agile coaches to guide adoption
  • Measure outcomes (cycle time, customer satisfaction) not just activity (velocity, burndown)

Prevention: Understand that Agile is a cultural shift, not just a process change. Invest accordingly in training, coaching, and mindset changes.

Mistake #5: Choosing Methodology Based on Team Preferences, Not Project Needs

Problem: Letting teams choose their preferred methodology regardless of project constraints, customer needs, or organizational context.

Why It's Problematic: Different projects have different success factors. Applying the same methodology universally ignores context-specific requirements.

Fix:

  • Evaluate each project against decision framework criteria
  • Tailor methodology selection to project characteristics
  • Build team capability in both Agile and Waterfall approaches

Prevention: Establish clear methodology selection guidelines based on project factors (requirements stability, customer availability, regulatory needs).

Mistake #6: Ignoring Organizational Culture and Readiness

Problem: Implementing Agile in command-and-control cultures without addressing cultural misalignment.

Why It's Problematic: Agile requires trust, autonomy, and empowerment. Hierarchical cultures create friction that undermines Agile practices.

Fix:

  • Start with leadership alignment and cultural assessment
  • Address organizational impediments before scaling Agile
  • Consider gradual adoption with pilot teams demonstrating value

Prevention: Conduct organizational readiness assessments before committing to Agile transformation.

Mistake #7: Over-Documenting in Agile or Under-Documenting in Waterfall

Problem: Agile teams create excessive documentation defeating flexibility, or Waterfall teams skip critical documentation creating knowledge gaps.

Why It's Problematic: Documentation should match methodology needs—Agile needs just enough, Waterfall needs comprehensive coverage.

Fix:

  • In Agile: Document what's necessary for knowledge transfer, compliance, and maintainability—nothing more
  • In Waterfall: Ensure all requirements, designs, and test plans are thoroughly documented before proceeding

Prevention: Define documentation standards appropriate to your methodology choice and project constraints.

Mistake #8: Treating Methodology Choice as Permanent

Problem: Organizations view methodology as a one-time decision rather than an ongoing evaluation.

Why It's Problematic: Project conditions change. What works in early phases may not work later. Inflexibility limits adaptation.

Fix:

  • Establish regular retrospectives to assess methodology effectiveness
  • Be willing to pivot if empirical evidence shows the approach isn't working
  • Consider phased approaches (e.g., Waterfall for infrastructure, Agile for software)

Prevention: Build in checkpoints to evaluate whether your chosen methodology still fits evolving project realities.


Real-World Implementation Examples

Example 1: SaaS Mobile Banking App (Agile)

Context: A financial technology startup building a mobile banking app for millennial customers in a competitive market.

Project Characteristics:

  • Unclear initial feature set—requires customer feedback to validate product-market fit
  • Rapid time-to-market critical due to competitive pressure
  • Continuous feature iteration based on user behavior analytics
  • Regulatory compliance required (PCI-DSS, banking regulations)

Methodology Choice: Agile (Scrum with 2-week sprints)

Implementation:

  • Sprint 0: Security architecture, compliance framework, CI/CD pipeline
  • Sprints 1-3: MVP with core features (account view, transfers, bill pay)
  • Continuous Delivery: Released MVP to beta users, gathered feedback
  • Sprints 4-8: Iterated based on user feedback, added social features, budgeting tools
  • Compliance Integration: Automated security scanning in CI/CD, compliance reviews in Definition of Done

Outcome: Launched MVP in 3 months, achieved 10,000 users in 6 months, pivoted features based on actual usage patterns. Agile enabled rapid adaptation to user feedback while maintaining compliance.

Example 2: Medical Device Firmware (Waterfall)

Context: A medical device manufacturer developing firmware for an FDA-regulated insulin pump.

Project Characteristics:

  • Requirements must be traced to FDA design controls
  • Comprehensive documentation required for 510(k) clearance
  • Hardware constraints fixed (processor, memory, power)
  • Safety-critical system where defects could cause patient harm
  • Changes post-design extremely costly due to re-validation requirements

Methodology Choice: Waterfall (with risk-based verification)

Implementation:

  • Requirements Phase: Detailed requirements specification with traceability to design controls (3 months)
  • Design Phase: Software architecture, detailed design, hazard analysis (2 months)
  • Implementation Phase: Coding per design spec, code reviews, static analysis (4 months)
  • Verification & Validation: Unit testing, integration testing, system testing per test protocols (3 months)
  • FDA Submission: Design history file, risk analysis, test results (2 months)

Outcome: Achieved FDA 510(k) clearance on first submission. Waterfall's comprehensive documentation and planning ensured regulatory compliance and patient safety. Changes post-design were minimal due to thorough upfront requirements analysis.

Example 3: Enterprise ERP Implementation (Hybrid)

Context: A global manufacturing company implementing SAP ERP across 15 facilities in 8 countries.

Project Characteristics:

  • Core ERP modules well-defined (finance, inventory, procurement)
  • Customizations and integrations required discovery and iteration
  • Fixed budget and timeline constraints (18 months, $15M)
  • Change management and training critical for adoption
  • Go-live required coordinated cutover across facilities

Methodology Choice: Hybrid (Waterfall for core, Agile for customizations)

Implementation:

  • Phase 1 (Waterfall): Requirements gathering, core ERP configuration, data migration strategy (6 months)
  • Phase 2 (Hybrid): Core ERP testing (Waterfall), Custom integrations and reports (Agile sprints) (6 months)
  • Phase 3 (Waterfall): User acceptance testing, training, cutover planning (4 months)
  • Phase 4 (Waterfall): Phased go-live across facilities (2 months)

Outcome: Successfully implemented on time and budget. Waterfall provided governance and coordination for core ERP, while Agile enabled flexibility for customizations and integrations that required iteration based on user feedback.


Test Your Knowledge

Test your understanding of Agile vs Waterfall methodologies with this comprehensive quiz covering methodology selection, key differences, and real-world scenarios.

Quiz on

Your Score: 0/15

Question: According to the 2020 Standish Group Chaos Study, how much more likely are Agile projects to succeed compared to Waterfall projects?


Conclusion

The choice between Agile and Waterfall is not about which methodology is universally superior—it's about which approach best fits your project's specific constraints, team capabilities, and organizational context.

Agile thrives in environments with evolving requirements, continuous customer engagement, and tolerance for adaptive planning. Its iterative approach enables rapid feedback, early risk discovery, and flexibility to respond to changing market conditions. According to the 2020 Standish Group Chaos Study, Agile projects demonstrate significantly higher success rates in technology initiatives.

Waterfall excels when requirements are stable, regulatory compliance demands comprehensive documentation, and projects require predictable timelines and budgets. Its structured approach provides clarity, thorough planning, and well-defined milestones that align with traditional project governance.

Key Takeaways:

  1. Context Matters: Use the decision framework and matrix provided to evaluate your project's unique characteristics rather than adopting methodologies based on trends or preferences.

  2. Hybrid Approaches Are Valid: Many successful projects blend Agile and Waterfall elements to address specific constraints. Water-Scrum-Fall, Agile with stage gates, and SAFe offer structured approaches to combining methodologies.

  3. Industry Considerations: Different sectors face unique pressures—SaaS companies benefit from pure Agile, medical device manufacturers often require Waterfall, and financial services frequently adopt hybrid models.

  4. Avoid Common Pitfalls: Fake Agile, methodology mismatch with project needs, and inadequate stakeholder involvement are preventable mistakes that derail projects.

  5. Methodology Choice Is Not Permanent: Establish checkpoints to evaluate whether your chosen approach still fits evolving project realities. Be willing to adapt.

Next Steps:

  • Assess Your Current Projects: Apply the decision matrix to your active projects and validate whether your current methodology aligns with project characteristics.
  • Build Capability: Invest in training and coaching for both Agile and Waterfall approaches so teams can apply the right methodology contextually.
  • Start Small: If transitioning methodologies, begin with pilot projects to learn, gather empirical evidence, and refine your approach before scaling.
  • Measure Outcomes: Track success metrics (customer satisfaction, time-to-market, defect rates) rather than just process compliance (velocity, documentation completeness).

Remember, project success ultimately depends on the commitment, collaboration, and adaptability of the people implementing the methodology—not the methodology itself. Choose wisely, execute diligently, and remain open to learning and adjustment.

Continue Reading

Frequently Asked Questions (FAQs) / People Also Ask (PAA)

Can Agile and Waterfall methodologies be used together in the same organization?

How long does it take to transition from Waterfall to Agile?

Is Agile more expensive than Waterfall?

What is the role of project managers in Agile vs Waterfall?

How does testing differ between Agile and Waterfall?

Can remote or distributed teams effectively use Agile?

How do contracts work with Agile vs Waterfall?

What happens when stakeholders cannot commit to continuous Agile involvement?

How does DevOps relate to Agile and Waterfall?

Is there a 'best' Agile framework (Scrum, Kanban, XP, SAFe)?

How do you measure productivity in Agile vs Waterfall?

What is the minimum team size for Agile vs Waterfall?

How does documentation differ between Agile and Waterfall beyond volume?

Can Agile work for hardware or physical product development?

What is the role of documentation in meeting audit and compliance requirements in Agile?
